How to Budget for Building a House: A Site Manager's Checklist

Most people who build a house go over budget. Not because they were careless, but because a house budget is not one number: it is fifty-odd cost lines, a dozen contracts, a stack of finish decisions and a schedule that moves every week. This is how a construction site manager would budget and control the build of his own home.

1. Start from cost lines, not from a price per square foot

A price per square foot is useful to check if a project is realistic. It is useless to control it. Break the build into phases and lines you can actually buy: plans and permits, site work, foundation, framing, roofing, windows and doors, exterior finishes, plumbing, electrical, HVAC, insulation and drywall, interior trim and paint, cabinets and countertops, flooring and tile, appliances and fixtures, driveway and landscaping, and supervision. On a typical custom home that is around 55 to 60 lines.

For every line you want five numbers: the budget, the contract you signed, the approved changes, what you have paid, and the forecast final cost. The forecast is the one that matters: contract plus approved changes where you have signed, and your budget where you have not.

2. Keep a real contingency: 10 to 15%

On a new build the ground, the weather and late decisions will cost money you did not plan. Keep 10 to 15% of the build cost as contingency and treat it as spent money, not as spare cash for upgrades. Every week, compare your forecast final cost with your base budget: the difference is how much contingency you have used. If half of it is gone before the drywall goes up, stop and re-plan.

3. Compare quotes by what they include

Get three quotes for every major trade and put them side by side, line by line. The cheapest quote is often cheap because something is missing: hardware install, permit fees, a lower-efficiency unit, a lower drywall finish level. Write down what each quote includes and excludes before you look at the total.

4. Treat allowances as estimates, not choices

Builders price cabinets, countertops, flooring, light fixtures and appliances as allowances. An allowance is the builder's guess. Whatever you choose above it is extra cost, usually billed as a change order. Track each allowance against the price of what you actually pick, item by item, and decide early: late decisions are the main cause of delays.

5. Every change in writing, before the work

A change order needs three things before anyone picks up a tool: a description, a price and the number of days it adds. Approve or reject it. Never "we'll see". Keep a running total of approved changes against your contingency.

6. Never pay ahead of the work

Pay for work in place, get a receipt or lien waiver with every payment, and keep 5 to 10% of each trade's payment until its punch list items are fixed. Log every payment against its budget line, and note whether it came from your own funds or a construction loan draw, so you always know how much of the loan is left.

7. Plan the cash, month by month

Spread the budget of each phase over its dates in the schedule and you get a monthly spending plan. Compare it with what you actually paid. If you are paying much faster than planned, you are either ahead of schedule or paying ahead of the work. Find out which.

8. Walk the house before it gets covered

Before the foundation pour, before insulation, before drywall: walk the site with a checklist and a phone. Photograph every wall before it is closed. You will want to know where the pipes and cables are for the next 30 years.

Free download: walk your site before each stage gets covered with the Home Building Stage Checklist, 42 checks from foundation pour to final walkthrough (Excel and Google Sheets).

A weekly 15-minute routine

  • Log the payments of the week against their budget lines.
  • Update % complete on the schedule.
  • Check which selections need a decision in the next two weeks.
  • Look at the forecast final cost and the contingency left.
  • Check what starts in the next three weeks and what is late.

The tool

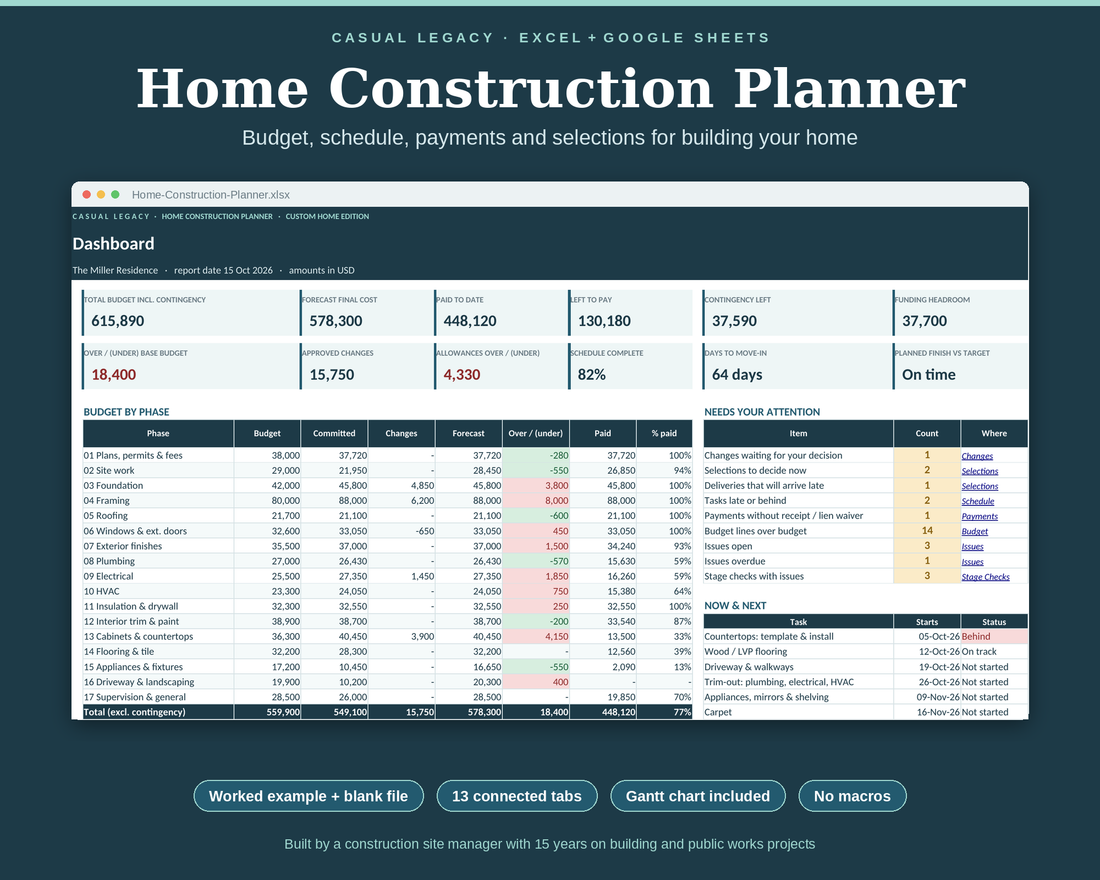

We built all of this into one workbook: the Home Construction Planner. Budget with 56 cost lines, quote comparison, change orders, payments and loan draws, selections and allowances, a Gantt schedule that draws itself, monthly cash flow, 42 stage checks and a dashboard that tells you each week if you are on budget and on time. Excel and Google Sheets, with a fully worked example of a 2,600 sq ft custom home.

Written by a construction site manager with 15 years on building and public works projects. A planning guide, not legal or financial advice.
